Update on Stillwater River Road rockslide

The Stillwater County Commissioners have issued an update on the Stillwater River Road rockslide. Standing rock from the slide has closed the road to through traffic from Absarokee to Nye since June 3, 2015.

Photo: Carol Arkell

According to the update, Stillwater County has awarded a contract to HI TECH Rockfall Construction, a general contractor specializing in rockfall mitigation and slope stabilization systems located in Forest Grove, Oregon.

The contracted work includes:

  1. removing (scaling) loosened and/or unstable blocks of rock from a near-vertical, approximately 250- to 300-foot-high slope adjacent to Stillwater River Road
  2. drilling weep holes into the rock slope
  3. making reasonable effort to prevent scaled material from entering the Stillwater River
  4. removing, hauling, and disposing of existing slide debris covering the road
  5. removing, hauling, and disposing of debris generated by the scaling operations
  6. removing any rocks which land or come to rest in the channel of the Stillwater River below the ordinary high water mark.

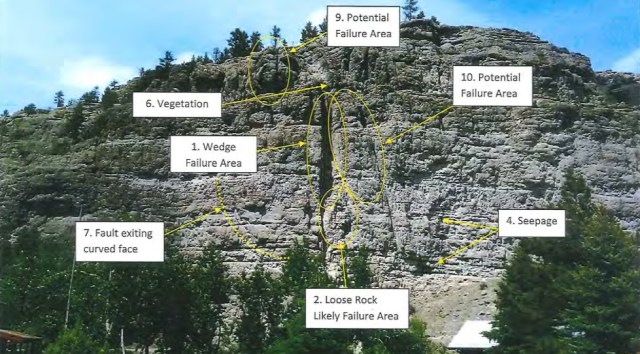

Stillwater River Road rockslide photo2

Work will begin on January 9, weather permitting. Once the project has begun, the contract allows for a sixty day project time, with possible delays for poor weather.

When the work is complete, the road will be reopened, approximately two years after the slide occurred. Not a shining example of effective county government, but residents will welcome the completion of the work.

The County Commissioners ask that residents recognize that this is dangerous work, and request that people stay out of the area while the work is being performed.

Previous posts on this topic:
Stillwater River rock slide reminds us of the dangers of drilling
Stillwater County residents: public meeting on Stillwater River Road closure this Thursday
Important documents for Thursday’s meeting on the Stillwater River Road closure
Stillwater County Commissioners ignore County residents on issue after issue. This has to change

Update, January 11
The Commissioners have updated the status to indicate that work on the road project is delayed due to weather conditions. Work is now scheduled to start on February 20.

Update, February 27:
I received a communication from County Commissioner Mark Crago that the start of work has been postponed to March 27.

Update, April 3:
The County Commissioners sent out the following update on April 3:

            On March 23, 2017, DES State Hazard Mitigation Officer Nadene Wadsworth was in Columbus to discuss progress on the FEMA grant for the rockslide project.  The FEMA grant is a “Pre-Disaster Mitigation” grant or PDM grant.  Stillwater County began the application process for this grant in May 2016.  Please recall Stillwater County also applied for this type of FEMA grant in 2015 but the application was denied so the County had to re-apply again in 2016.

            As with most grant requests, it is a time consuming process.  Stillwater County’s rockslide project was one of ten grant applications received from various entities in Montana in 2016 and fortunately, Stillwater’s project was identified as one which FEMA wanted to further review.  The grant applied for is $1.86 million dollars.

            At this time, FEMA is conducting a final environmental review of the proposed project.  According to Officer Wadsworth, this review is progressing well because the grant application contained a great deal of environmental information.  The only minor set-back has been with the area the County identified as the dump site for the rocks from the project.  The original site was to be at the Moraine Fishing Access, however, FEMA determined the site has tipi rings, and is a protected area.  Once the County was given that information, the County worked with Stillwater Mine to locate an alternative site for the rocks.  The County has now proposed an area near the Mine’s Hertzler Tailings Pond and is awaiting FEMA approval.

            The County stands ready to begin the project, however, the County cannot begin actual rock-moving work until the PDM grant has been officially awarded.  Crews were slated to begin rock removal this week, however, if crews were to begin now, the grant award of $1.86 million could potentially face denial.  The projected costs of the rock project is at $2.48 million so the grant award is a crucial component.

            The County Commissioners and Mark Schreiner expressed concerns about this delay to Officer Wadsworth.  She fully understands that all of you have been waiting for a resolution for a long time and assures the Commissioners, they are working as quickly as possible on their end to get this process finalized.  The County remains hopeful FEMA will provide us an answer within the next few weeks so work can begin.

Frankly, I’m confused. On January 4, the job was awarded and work was to begin in five days, weather permitting. Now there are impediments and the County is “hopeful FEMA will provide us an answer within the next few weeks so work can begin.”

Everyone understands that weather and government grants can slow things down, but the County is wildly inconsistent in its communications on this project.

Update, May 16: The Billings Gazette today published an article on the rockslide, linking to this blog and quoting local residents Jerry Sternad and Shirley Stafford.

Update, June 8: Today’s communication from Stillwater County:

“As was announced in the media several weeks ago, FEMA awarded Stillwater County a grant to help with the cost of the Stillwater River Road rockslide situation.  The rockslide project has an estimated price tag of roughly $2.5 million, and the grant will cover approximately $1.9 million of that amount.”

Update, June 22: Stillwater County has published the work schedule for opening Stillwater River Road. Work is scheduled to begin on Monday, July 24, and is to conclude four weeks later with the opening of the road on Friday, August 18. The existing rock debris will be cleared in the first week. The largest amount of time will be spent removing (scaling) loosened and/or unstable blocks of rock from the cliff and building a containment system to prevent the scaled material from getting into the river. If the work is completed on schedule, the road will be opened 807 days from the original rockslide.

Work schedule submitted by Hi-TECH Rockfall Construction. Click to enlarge.
